Transport Secretary Calls HS2 Project ‘Appalling Mess’ as 2033 Target Abandoned

Billions of pounds in taxpayer funds have been lost to shifting project plans, weak contracts, and poor oversight, Heidi Alexander told Parliament.
Transport Secretary Calls HS2 Project ‘Appalling Mess’ as 2033 Target Abandoned
On his first day as HS2 CEO, Mark Wild (right) visits the Old Oak Common station box site alongside rail minister Lord Hendy (left) during preparations for completing the 4.5-mile HS2 tunnelling to London Euston, on Dec. 2, 2024. Jonathan Brady/PA
|Updated:
0:00

Transport Secretary Heidi Alexander has confirmed that the HS2 high speed rail project will not be running by 2033, citing ineffective contracts, constant scope changes, and poor management as key reasons for the delay.

Speaking in the House of Commons on Wednesday, Alexander called the state of the project “an appalling mess” and pledged to bring it under control.

“It gives me no pleasure to deliver news like this. Billions of pounds of taxpayers’ money has been wasted by constant scope changes, ineffective contracts, and bad management,” she told MPs.

While she confirmed that the line will not be operational by the original 2033 target, she did not set a new completion date.

The announcement follows the government’s £15 billion investment in public transport projects in England’s city regions and ahead of its Infrastructure Strategy and Industrial Strategy, which is expected to unveil billions of pounds in investment.

Billions Spent, Little Progress

HS2 was originally planned to connect London to Birmingham, Manchester, Leeds, York, and the East Midlands Parkway.
In 2023, however, the northern sections were cancelled by the Conservative government, citing delays, ballooning costs, and changes in travel demand after the COVID-19 pandemic.

The remaining stretch—between London and the West Midlands—remains under construction.

Shadow transport secretary Gareth Bacon acknowledged the Conservative Party’s failures while in government.

He said that “mistakes were made” in the delivery of the HS2 and admitted the decision to cancel the northern leg, as well as introduce the alternative “Network North,” was a response to the mishandling of the scheme.

“I will not today pretend that the Network North was not a product of mistakes we made in the handling of HS2, because it clearly was. As a country we must learn from those mistakes and we must not repeat them,” he said.

Cost Management

The first phase of the project was originally projected to cost £20.5 billion in 2012. That figure has since more than doubled to an estimated £56.6 billion.

Alexander criticised the lack of oversight in recent years and highlighted poor cost management at HS2 Ltd.

“Quite simply, there have been too many dark corners for failure to hide in. The ministerial taskforce set up to provide oversight of HS2 had inconsistent attendance from key ministers, including the then-transport secretary and the then-chief secretary to the Treasury,” she said.

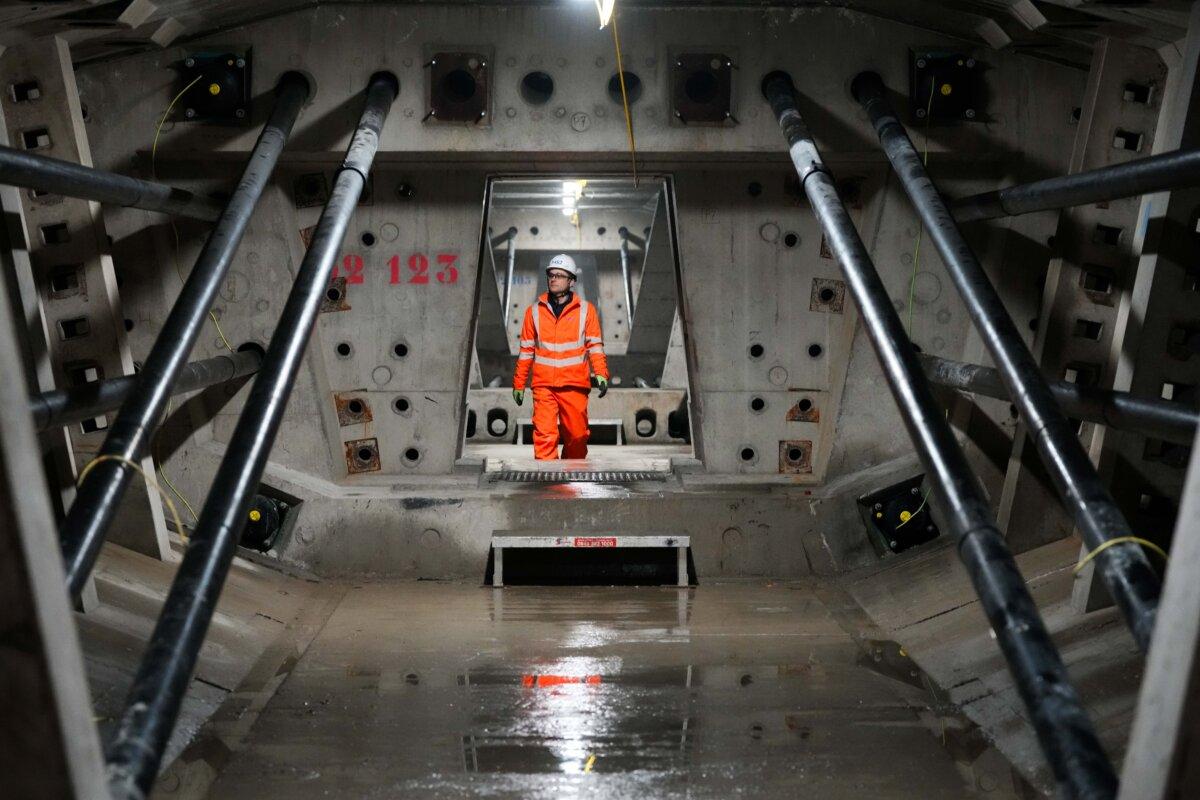

Engineers work inside the access void below the deck of the HS2 viaduct at the Delta Junction construction site in Sutton Coldfield, England, on Feb. 12, 2025. (Christopher Furlong/Getty Images)
Engineers work inside the access void below the deck of the HS2 viaduct at the Delta Junction construction site in Sutton Coldfield, England, on Feb. 12, 2025. Christopher Furlong/Getty Images

The government has now reinstated full senior attendance on the taskforce and established new performance and shareholder boards to increase accountability.

A review led by infrastructure adviser James Stewart found deep flaws in the project’s delivery.

Alexander said the government has accepted all of the review’s recommendations, including reforming how HS2 estimates costs and structures contracts.

She told MPs that HS2 must “fundamentally” change the approach to estimating costs and work with suppliers so their contracts incentivise saving money for taxpayers.

New leadership was appointed at HS2 Ltd in December, with Mark Wild taking over as chief executive.

“We’ve made clear to the new Chief Executive Mark Wild that the priority is building the rest of the railway safely at the lowest reasonable cost, even if this takes longer,” Alexander said.

The transport secretary also warned that any proven cases of fraud within the project would be dealt with severely.

Euston Plans Over Budget

One of the most costly setbacks has been the planned London terminus at Euston.

Between 2019 and 2023, HS2 Ltd submitted designs for the station that were nearly £2 billion over budget. When asked for a more affordable version, the alternative plan was £400 million more expensive than the original.

“The word ‘affordable’ was clearly not part of the HS2 lexicon,” Alexander said.

Secretary of State for Transport Heidi Alexander departs the weekly Cabinet meeting at 10 Downing Street in London on Jan. 28, 2025. (Leon Neal/Getty Images)
Secretary of State for Transport Heidi Alexander departs the weekly Cabinet meeting at 10 Downing Street in London on Jan. 28, 2025. Leon Neal/Getty Images

She also revealed that a ministerial taskforce created for the Euston project under the previous government “never met.”

Despite the challenges, she confirmed that funding is in place to begin tunnelling from Old Oak Common to Euston, with further details to be included in the government’s upcoming 10-year Infrastructure Strategy.

Falling Behind

Labour seeks to restore Britain’s reputation for delivering world-class infrastructure.

Responding to Reform UK leader Nigel Farage, who called for HS2 to be scrapped, Alexander said, “We are not going to be a country that spends over £30 billion on rail infrastructure but then never sees a train running on it.”

The comments come after a Public Accounts Committee report last year warned that the UK lacks the skills and capacity to deliver its ambitious infrastructure plans over the next five years. Key shortages were identified in engineering, technical fields, project management, and design.

On Monday, ministers announced new rules aimed at boosting high-quality British jobs and skills by tightening the criteria for awarding major government contracts.

“In the past, companies have made pledges when bidding for contracts but don’t always follow through,” the Cabinet Office said in a statement.

Under new plans, public bodies would be required to give more weight to companies that commit to creating UK jobs and investing in skills. The changes would apply to major government projects, including transport, schools, and hospitals.
