Pentagon Plans Undermined by Chronic Delays, Cost-Overruns, Insufficient Industrial Capacity

‘We’re not ready for the war that looks to be looming,’ Rep. Jake Ellzey said.
Pentagon Plans Undermined by Chronic Delays, Cost-Overruns, Insufficient Industrial Capacity

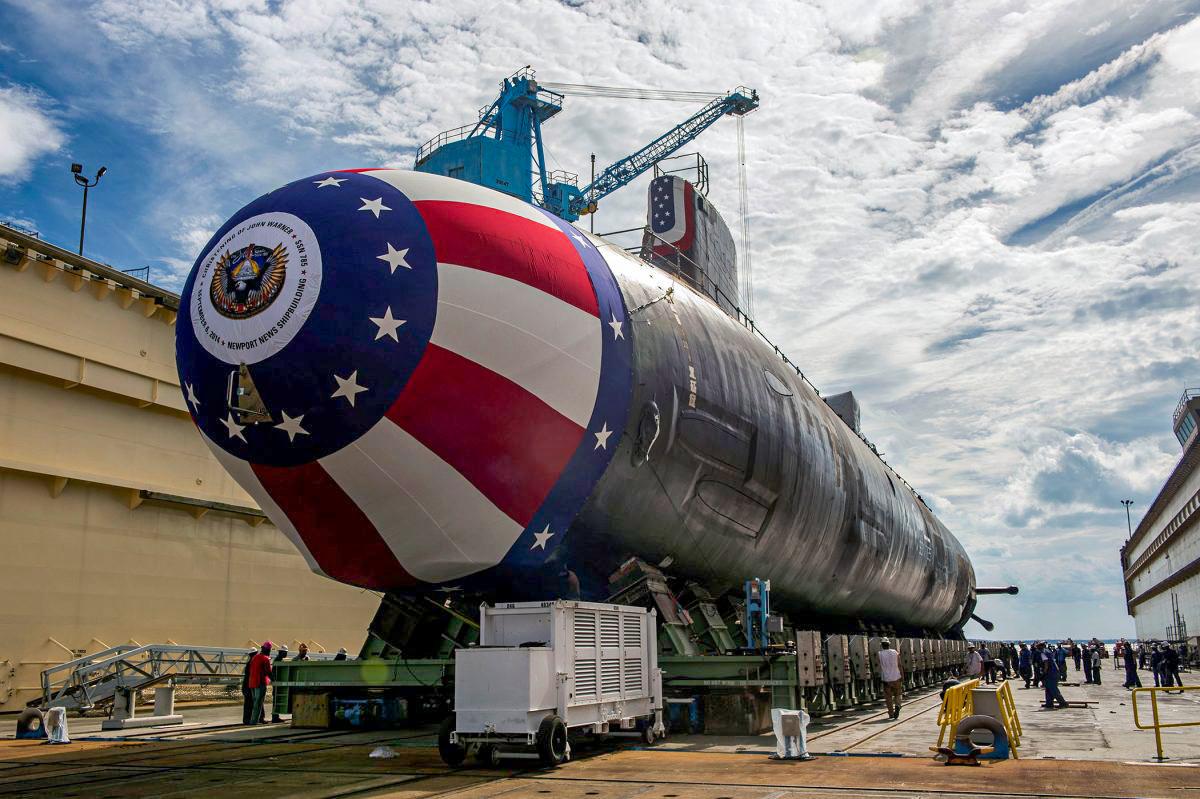

The Virginia-class attack submarine USS John Warner is moved to a floating dry dock in Newport News, Va., on Aug. 31, 2014. (U.S. Navy/John Whalen/Huntington Ingalls Industries/Reuters)
John Haughey
4/18/2024
Updated:
4/18/2024

For years, Congress has approved increasingly large defense budgets that include billions of dollars in annual allocations for arms and armaments procurement, shipbuilding, and research and development of new weapon systems.

In return for these billions, American taxpayers receive only millions back in the form of new arms, ships, and weapons systems each year. A bipartisan chorus of House Appropriations Committee critics said during a defense budget hearing on April 17 that this inefficient cycle subverts national security and must end.

The Department of Defense (DOD) is “plagued by bureaucracy,” mired in regulatory minefields, and burdened with antiquated acquisition systems in which “zombie programs” subsist while innovations wither in “death valleys,” they told Secretary of Defense Lloyd Austin and Joint Chiefs Chair Gen. C.Q. Brown during a 150-minute hearing on the Pentagon’s proposed $895.2 billion defense budget request for fiscal year 2025 (FY25).

Despite these administrative and regulatory bottlenecks, there are production backlogs across the DOD’s procurement spectrum because the nation’s defense industrial base—no longer the Cold War-era “military-industrial complex”—does not have the capacity to fill the Pentagon’s wish lists on time and within budget.

That was before the surge in demand for arms, munitions, and weapons systems, including $44.2 billion for Ukraine since 2022, outpaced the capacity for domestic manufacturers to produce them, raising concerns about the nation’s ability to keep its forces armed in simultaneous sustained, multitheater conflicts.

“We need to be on wartime footing,” Rep. Jake Ellzey (R-Texas) said.

“I would say that our acquisitions process is broken. We need to bypass some of the requirements we have because ... I’m a little worried about what we have right now. We’re not ready for the war that looks to be looming.”

Rep. Betty McCollum (D-Minn.) agreed.

“I’m concerned about our nation’s ability to address emerging threats,” she said. “Many of the major systems that we rely on for each of the services are delayed and require additional funds from their original stated contracts. This needs to stop.”

Endemic Delays, Endless Extensions

Defense Appropriations Subcommittee Chair Ken Calvert (R-Calif.) said that “over-costs and significantly delayed weapon system acquisition” are hobbling DOD programs, which poses a long-overlooked but increasingly glaring national security risk.

“Pick a service; I can point you to systems that fit this mold,” he said.

The Navy’s Columbia-class ballistic missile and Virginia attack submarines “are both delayed despite being dubbed the service’s No. 1 priority,” according to Mr. Calvert.

That’s why the Navy is only ordering one of the two Virginia-class subs its shipbuilding plan calls for in FY25, Mr. Austin said.

“There’s a backlog, and rather than increase that backlog, the right thing to do, in my view, is to invest in the industrial base in terms of giving [it] the means to expand capacity by recruiting and retaining the right people, making sure that they can strengthen their supply chains,” he said.

Mr. Austin said that in both FY23 and FY24, the DOD received $1.9 billion to invest in a submarine industrial base. The DOD is asking for $4 billion in the FY25 budget request and another $3.3 billion in the pending supplemental funding bill.

Rep. Rosa DeLauro (D-Conn.) said the investments are late but welcome.

“The secret is well-known that the Navy is experiencing significant issues related to shipbuilding and, in particular, submarines,” she said. “We know we need more ships, more subs, but we lack the infrastructure and the workforce to stay on track. I want to be clear that the private sector could do more to help.”

The Minuteman III intercontinental ballistic missile in a training launch tube at Minot Air Force Base, N.D., in 2014. (Charlie Riedel/AP Photo)
The Minuteman III intercontinental ballistic missile in a training launch tube at Minot Air Force Base, N.D., in 2014. (Charlie Riedel/AP Photo)

In addition to shipbuilding delays, Ms. DeLauro said there is “a significant backlog of ship and submarine maintenance” that will affect the Navy’s readiness.

Mr. Ellzey said the Marines’ request for 35 medium landing ships had been filtering about for five years before being approved in FY20.

“Here we are four years later and we still don’t have them,” he said.

The cost has now “ballooned to $350 million,” and the ships won’t be provided until 2027.

“And that’s assuming we pass the spending bills,” Mr. Ellzey said.

Mr. Calvert continued with his list of delayed, stalled, discontinued, forgotten, and frozen Pentagon weapons system programs in various stages of meter-running stasis.

“The Army spent over $2 billion developing FARA [Future Attack Reconnaissance Aircraft] only to cancel the program,” he said. “The Space Force GPS ground system is more than $3 billion over budget and seven years late and it’s still not delivered.”

Mr. Calvert cited delays and cost-overruns with the Air Force’s Sentinel intercontinental ballistic missile, which will replace the Minuteman III, noting January’s DOD revelation that it will cost 37 percent more than last projected and take at least two years longer than estimated.

The Sentinel was estimated to cost $62.3 billion in 2015, but a Government Accountability Office cost estimate due by July could push the price tag beyond $130 billion.

“And, of course, there’s an entire hypersonic [missile] program, which has cost over $10.5 billion so far and produced not a single-fielded system,” Mr. Calvert said.

F-16V fighter jet with its armaments on display during an exercise at a military base in Chiayi, Taiwan, on Jan. 15, 2020. (Sam Yeh/AFP via Getty Images)
F-16V fighter jet with its armaments on display during an exercise at a military base in Chiayi, Taiwan, on Jan. 15, 2020. (Sam Yeh/AFP via Getty Images)

Lost Time, Bad Tidings

Ms. McCollum said delays and red tape mean that DOD’s “industrial partners” are “losing workers right and left after they’ve been trained, particularly in the shipbuilding industrial base.”

She called on the Pentagon, Congress, and the industry to “work together to ensure that there’s consistency because those jobs—and the people in them—are important to the national security of our nation.”

“There’s another component” to the snarl, Appropriations Committee Chair Tom Cole (R-Okla.) said.

“It is widely known that Taiwan has ordered billions of dollars’ worth of weapons from our country that haven’t been delivered,” he said. “Why have we not been able to help a country that literally is under enormous pressure from China in receiving weapons it’s actually paid for?”

Mr. Calvert said that despite chronic dysfunction, since the House began focusing on the issue in recent years, progress is being made, citing the $1 billion FY24 allocation for the DOD’s Defense Innovation Unit “along with the flexible authorities necessary to rapidly identify, contract, and deliver innovative technologies to the warfighter.”

He said he wants the Pentagon to create a “transition tracking action group” using advanced analytics “to track how the department delivers capability to the field” to speed up production and ensure that worthy projects don’t get derailed by “valley of death” funding gaps.

“We’re going to do everything we can to move capability as quickly as we can across the valley of death and get it into the hands of our warfighters,” Mr. Austin said, thanking lawmakers for providing “additional multiyear procurement authority” in the FY24 budget.

“That has been helpful in sending the right signal to the industrial base,” he said, calling the delays and capacity crunch “a complex picture” that only makes it more imperative to continue “expanding the industrial base capacity.”

Ms. DeLauro was among Democrats who said they found Republican concerns about delivering products on time and under budget ironic, considering that under GOP leadership, the FY24 defense budget was only adopted in March, with Pentagon spending plans routinely paralyzed in continuing resolution limbo.

“Many of my colleagues speak at length about wanting to achieve these goals, yet we pass a defense spending bill this year over five months late. I repeat, five months late,” she said. “I hope that we do not continue to play games with our federal spending process this year.”

Mr. Austin said: “The best way that we can help ourselves is to make sure that we receive an on-time budget. If you don’t get a budget on time, you’re not executing to your full capability. It has a significant impact on our ability to do a number of things, but you can’t buy back time.”

Mr. Ellzey agreed that time is of the essence.

“Today is April 17, 1940, in my mind because the winds of war are already blowing overseas in a way they haven’t in 80 years,” he said. “I wish it was April 17, 1946, when we could talk about cuts, but we can’t. We should be on a wartime footing in this country right now.”

John Haughey is an award-winning Epoch Times reporter who covers U.S. elections, U.S. Congress, energy, defense, and infrastructure. Mr. Haughey has more than 45 years of media experience. You can reach John via email at [email protected]
